Cambridgeport Parks

Playstructure at Alberico Park - November 2012

The City of Cambridge is in the process of renovating three neighborhood parks in Cambridgeport. Alberico Park, David Nunes (Old Morse) Park, and Fulmore Park are small to moderately sized parks located in Cambridgeport along Allston Street and Sidney Street. Together, these neighborhood focused parks are an important part of the open space fabric of the surrounding community.  The renovation process will provide a unique opportunity to create play environments and gathering spaces for these 3 parks in the context of the open space system in the neighborhood, in order to provide a wide range of different activities for users of all ages and physical abilities.

Park improvements throughout the city are also guided by the goals of Healthy Parks and Playgrounds Initiative.

Check out these articles and short video regarding play!

Email Sign up for the Cambridgeport Parks project email list.


June 2013

Construction on Alberico, Fulmore, and David Nunes (Old Morse) Parks is continuing and is currently anticipated to be completed during the month of July (weather permitting). We do apologize for the inconvenience of having these 3 parks closed while they are being renovated and thank neighborhood residents in particular for their continued patience.

The next stages of the construction process include continued irrigation work as well as loaming and sodding for new grassy areas, installing initial layers of rubber surfacing materials, completion of play structures, site lighting, additional planting work, final paving layers, and installing fencing and gates.

Please note that as with any construction project, even at this stage in the process, there are still factors that can affect the final schedule.

Any parking restrictions will be posted at least 24 hours in advance. Please be sure to check posted signs for exact dates and times to avoid being ticketed and towed. General work hours will be 7:00 A. M. to 4:00 P. M., Monday through Friday.

If you have any questions regarding parking, please contact Jane Demoulas, Clerk of the Works, DPW at 617/349-4871 or jdemoulas@cambridgema.gov.

For other questions please contact Taha Jennings, Community Development Department at 617/349-4603 or tjennings@cambridgema.gov

April 2013

Spring has arrived and significant construction activity has resumed at the Cambridgeport Parks, which are approaching completion (currently estimated for late June/early July). The next stages of the renovations will include the installation of nature inspired play equipment and seating areas, irrigation systems, rubber surfacing under the play structures, and landscape plantings.

Any parking restrictions will be posted at least 24 hours in advance. Please be sure to check posted signs for exact dates and times to avoid being ticketed and towed. General work hours will be 7:00 A. M. to 4:00 P. M., Monday through Friday.

Please keep in mind that the parks will remain completely closed during the renovations.

If you have any questions regarding parking, please contact Jane Demoulas, Clerk of the Works, DPW at 617/349-4871 or jdemoulas@cambridgema.gov.

For other questions please contact Taha Jennings, Community Development Department at 617/349-4603 or tjennings@cambridgema.gov

December 2012

Renovations to Alberico, Fulmore and David Nunes (Old Morse) parks are proceeding on schedule for anticipated completion in spring 2013!

Click on the Images tab to see the latest construction photos.

Site work will continue in December and throughout the winter months (weather permitting). General work hours will be 7:00 A. M. to 4:00 P. M., Monday through Friday. Any parking restrictions during the winter months will be posted on a week- to- week schedule. During periods of inclement weather “No Parking” signs will be removed (and will be reposted 24 hours in advance of work resuming).

If you have any questions regarding parking, please contact Jane Demoulas, Clerk of the Works, DPW at 617/349-7871 or jdemoulas@cambridgema.gov.

For other questions please contact Taha Jennings, Community Development Department at 617/349-4603 or tjennings@cambridgema.gov

November 2012

Over the next few weeks, the site preparation and earthwork phase will be concluding and new trees and equipment will be planted and installed.

Parking restrictions for the month of November have been posted at the three Cambridgeport parks. Please be sure to check posted signs for exact dates and times to avoid being ticketed and towed. General work hours will be 7:00 A. M. to 4:00 P. M., Monday through Friday.

August 2012

Construction on the new Fulmore Park in Cambridgeport is now underway. The new park will include a range of activities including blocks, waterplay, a water pump table, sand play, a circular path, seating areas, and landscaping with small hills, ornamental trees and plantings. It is anticipated that the park will re-open in Spring 2013.

July 2012

Construction on the new David Nunes (Old Morse) Park is underway. The new park will include a new community gathering space, challenging play structures, opportunities for active play, water play, a basketball court, and tolerant, visually appealing plantings and landscaping.

June 2012

On Wednesday, June 27, 2012 the City’s contractor JNJ Sacca, Inc. began site improvements at Alberico Park. JNJ Sacca will begin demolition and remove wooden playground equipment, benches and tables, interior concrete and asphalt surfacing, wooden light poles, perimeter chain link fencing and gates. JNJ Sacca will coordinate with City Parks and Urban Forestry on selective tree trim and removal. Demolition will continue through the month of July. Site preparation and earthwork will follow demolition and continue throughout the summer. Construction updates will be posted at the site and on the web.

March 2012

On March 22, 2012 a second public meeting was held to discuss upcoming renovations to Alberico Park, David Nunes Park, and Fulmore Park, all located in Cambridgeport.

If you would like to be notified of future meetings or would like more information please contact Taha Jennings at 617/349-4603 or email at tjennings@cambridgema.gov.

Construction on the renovations to Alberico Park, David Nunes (Old Morse) Park, and Fulmore Park is underway! The City’s contractor JNJ Sacca, Inc. has begun site improvements at all 3 locations and together they will provide the neighborhood with a wide range of activities for users of all ages and physical abilities.

What to Expect During Site Improvements:

Over the next several weeks, the site preparation and earthwork phase will be completed and new equipment will begin to be installed.

Parking restrictions for the month of November have been posted at the three Cambridgeport parks. Please be sure to check posted signs for exact dates and times to avoid being ticketed and towed. General work hours will be 7AM to 4PM, Monday through Friday.

Site work will continue in December and throughout the winter months (weather permitting). Any parking restrictions during the winter months will be posted on a week- to- week schedule. During periods of inclement weather “No Parking” signs will be removed (and will be reposted 24 hours in advance of work resuming).

If you have any questions regarding parking, please contact Jane Demoulas, Clerk of the Works, DPW at 617/349-7871 or jdemoulas@cambridgema.gov.

For other questions please contact Taha Jennings, Community Development Department at 617/349-4603 or tjennings@cambridgema.gov.

Alberico Park, David Nunes (Old Morse) Park, and Fulmore Park are small to moderately sized parks located in Cambridgeport along Allston Street and Sidney Street. Together, these neighborhood focused parks are an important part of the open space fabric of the surrounding community.  The design concepts for each of these three parks reflect key design objectives (to build community, to build great places, to design parks for everyone, to balance passive and active uses, and to integrate the natural environment), comments from the public process, the City's approach to healthy play, and the unique opportunity in this instance to think about the design of three key neighborhood parks simultaneously.

Park improvements throughout the city are also guided by Healthy Parks and Playgrounds goal to provide play environments that are physically motivating, challenging, creative and imaginative and serve all ages, interests and levels of ability throughout the year.

Learn about the City’s Healthy Parks and Playgrounds Initiative!

  • David Nunes Park in Construction April 2013

    David Nunes Park taking shape! April 2013

  • Alberico in Construction

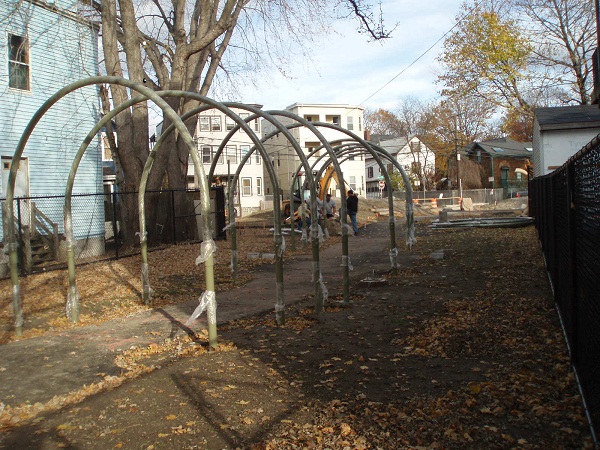

    Alberico Park walkway in Construction - November 2012

  • Ping Pong at David Nunes Park

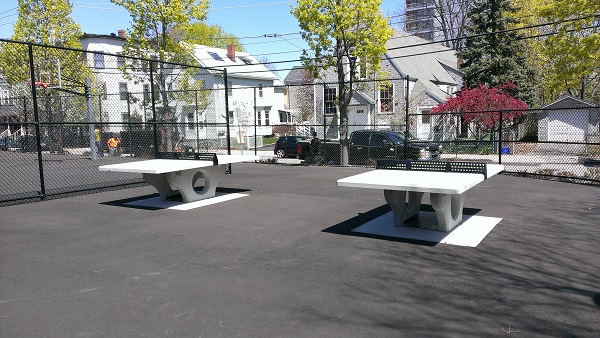

    Future Ping Pong Tables at David Nunes Park - April 2013

  • Fulmore Park in Construction

    Fulmore Park Under Construction - November 2012

  • Fulmore Park in Construction

    Fulmore Park Under Construction - November 2012

Responses to Frequently Asked Questions

What was the community process?

The process began in fall 2011, when the Community Development Department (CDD) sent out over 3,100 post cards to households which surround the three parks being renovated in Cambridgeport, introducing the process and inviting residents to the first community meeting.

There were two well-attended community meetings (in December 2011 and in March 2012). At the first meeting, City staff made a short presentation on the Healthy Parks and Playgrounds Initiative, the City’s design approach and objectives, and heard comments from the public as to how parks in the neighborhood are currently used and might be used in the future. At the second public meeting, concept plans for the renovated parks were presented and discussed. Over 40 online survey responses were submitted and residents provided additional input throughout the process via email, and telephone. CDD staff also presented concept plans to the Cambridgeport Neighborhood Association at their meeting on March 28th, 2012.

Stay in touch! Sign up for the Cambridgeport Park Renovations email list here

Why are all 3 parks closed at once?

Planning for the renovation of all three parks simultaneously provides a unique opportunity to create play environments and gathering spaces for these 3 parks in the context of the open space system in the neighborhood and allows the creation of a broader range of new and interesting experiences and activities for users of all ages and physical abilities.

In addition, renovating all three parks together allows for efficient recycling and reuse of materials between all of the sites including fencing fabric, granite curbing, some furniture, fill to create landscaping and hills, sand that can be reused in electrical conduit trenches, and even some tree logs that will be made into custom park furniture. It also allows for extremely efficient use of contractor resources, including machinery and labor, reducing both the overall cost of the project and providing a less energy intensive outcome.

We do recognize that closing all three parks during the summer can be an inconvenience for neighbors and park users and appreciate your patience and understanding during the construction phase. For a list of nearby parks and waterplay opportunities please refer to the City of Cambridge Open Space and Waterplay Maps

Why is it necessary to completely fence off the parks during construction?

During construction parks are fenced off primarily for public safety, but also for security and protection of materials and equipment that may need to be stored on site while awaiting installation.

Why is construction happening in the summer?

A summer construction schedule is very typical for outdoor construction projects in general, as well as park renovation projects in Cambridge. Many of the construction activities associated with the renovations require milder weather to complete in a timely manner, and are much more expensive and risky to undertake in freezing weather.

Are any trees being removed?

In general, only trees that are determined by the arborist to have been compromised, pose a safety hazard within these playgrounds, or that are in an advanced state of decline will be removed as part of the renovations. Every effort is made to include healthy existing trees in the new park, and to add new trees when possible.

Why does it sometimes seem as though nothing is happening on site?

There are a number of reasons why there may appear to be a lack of activity at one of the sites: the focus could be at one of the other park sites for a time, or the contractor may have to wait on the delivery of play equipment, water and lighting fixtures, and fabrication of the many custom features planned for these parks. The City makes every effort to plan, coordinate, and manage the construction process and schedule efficiently.

When will the parks reopen?

The newly renovated parks are expected to open in the spring of 2013. This will allow time to complete the major landscaping components of project in early spring.

For more information please contact Taha Jennings at 617/349-4603 or email at tjennings@cambridgema.gov.

To remove your contact information from the Cambridgeport Parks Mailing List please send an email to tjoyce@cambridgema.gov.  Please include the contact name(s), street address and/or email address you want removed from the mailing list.
