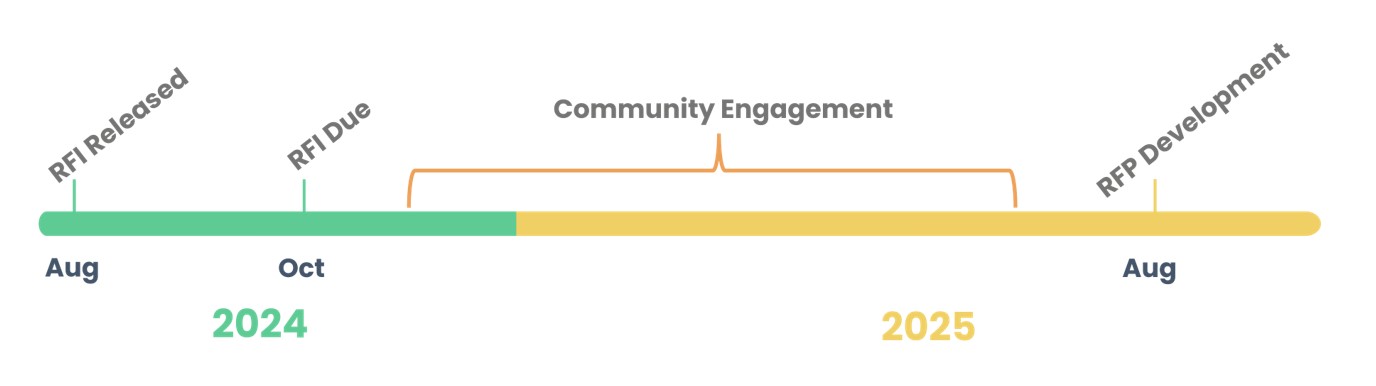

On August 8th, the City released a Request for Information seeking perspectives from the development community on how they would:

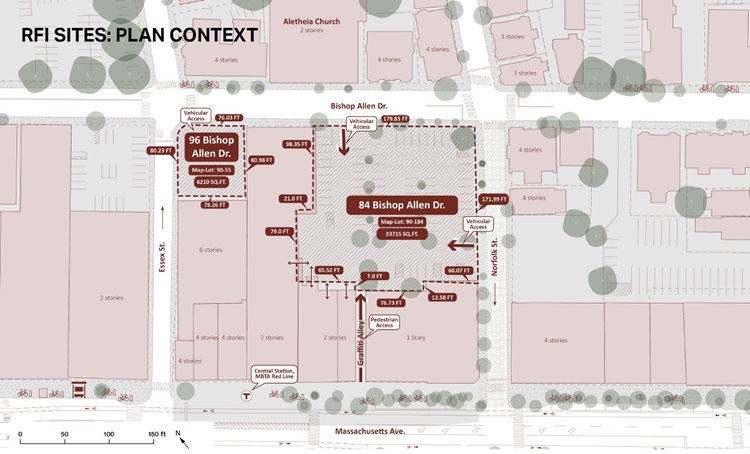

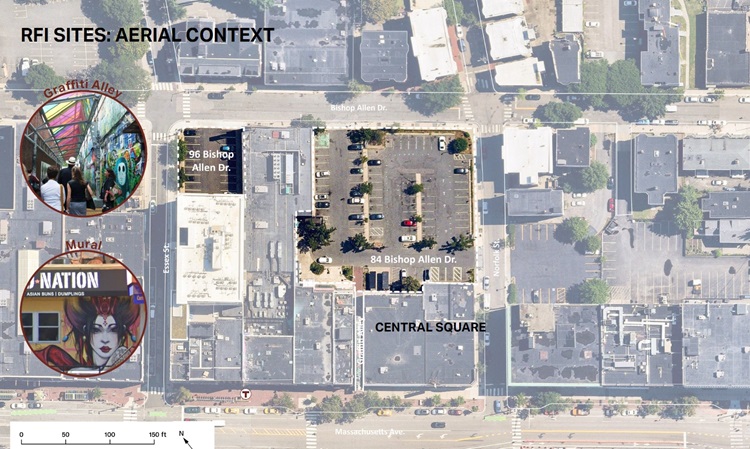

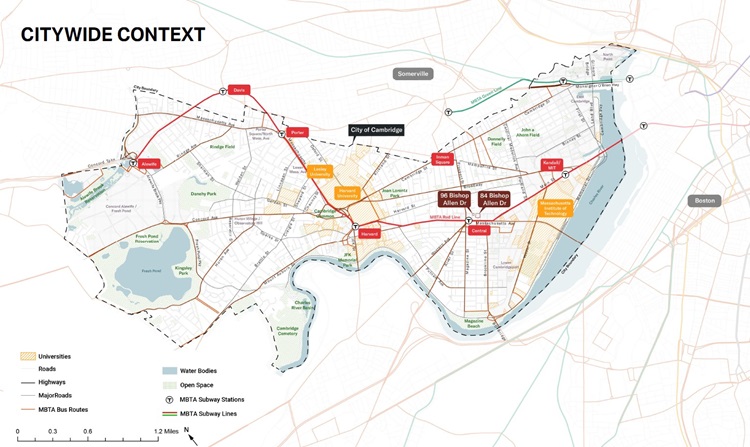

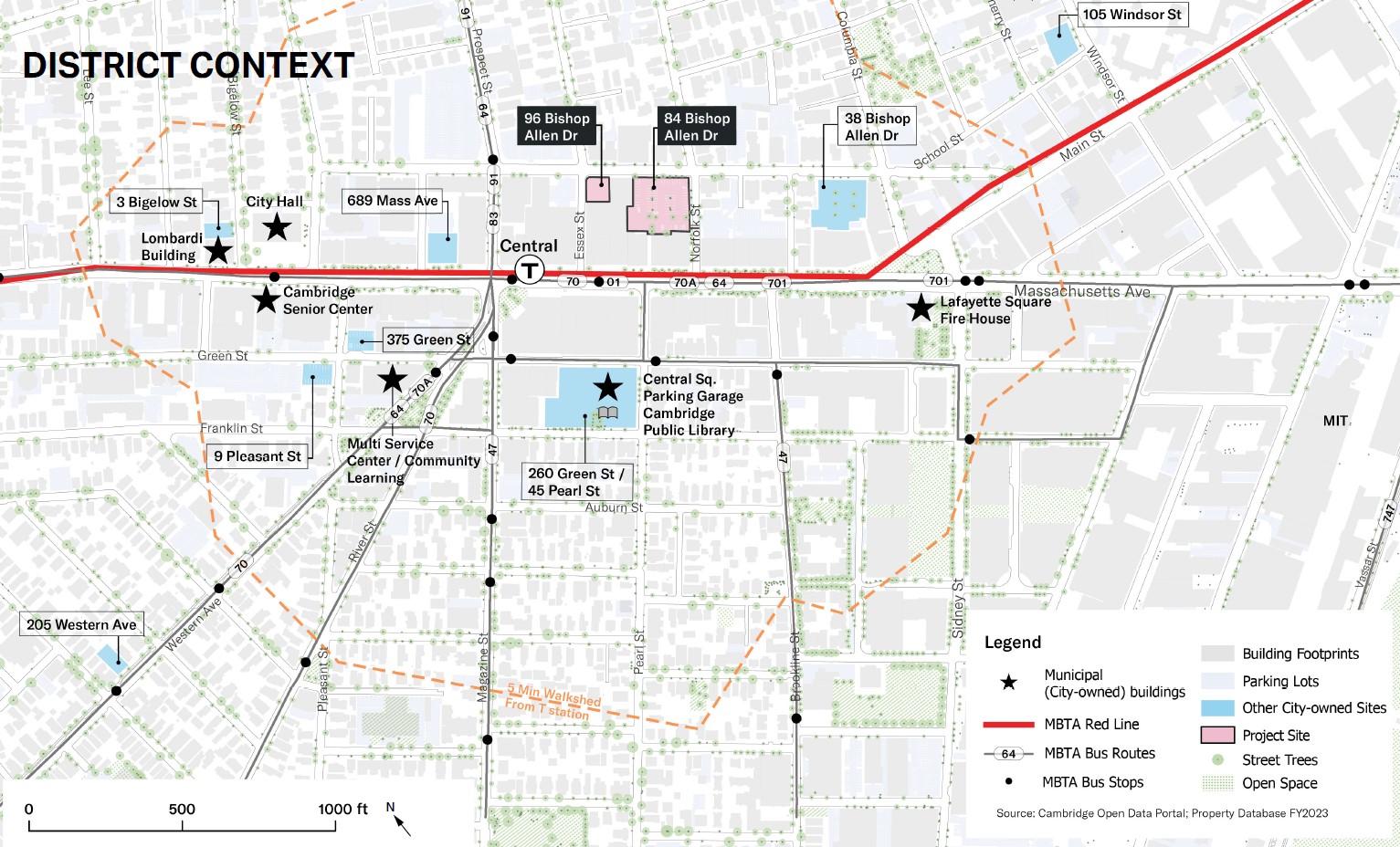

- approach redevelopment of the sites, and
- optimal ways to deliver the community objectives identified in the Central Square City Lots Study.
Six responses were received by the October 4th deadline from
- three for-profit developers,
- two non-profit developers, and
- one planning and design firm.
A summary memo of the responses was created by City staff and discussed by the City Council on March 31, 2025. A recording of that Council Meeting can be found here.
Access the RFI Summary Memo Here
